/*! This file is auto-generated */ .wp-block-button__link{color:#fff;background-color:#32373c;border-radius:9999px;box-shadow:none;text-decoration:none;padding:calc(.667em + 2px) calc(1.333em + 2px);font-size:1.125em}.wp-block-file__button{background:#32373c;color:#fff;text-decoration:none} Q130Q. Question: Here is a network with... [FREE SOLUTION] | ÷ÈÓ°Ö±²¥

÷ÈÓ°Ö±²¥

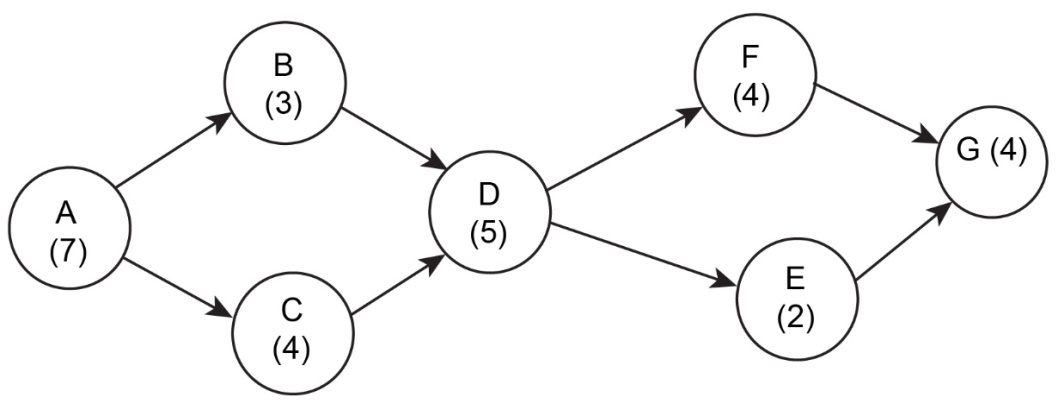

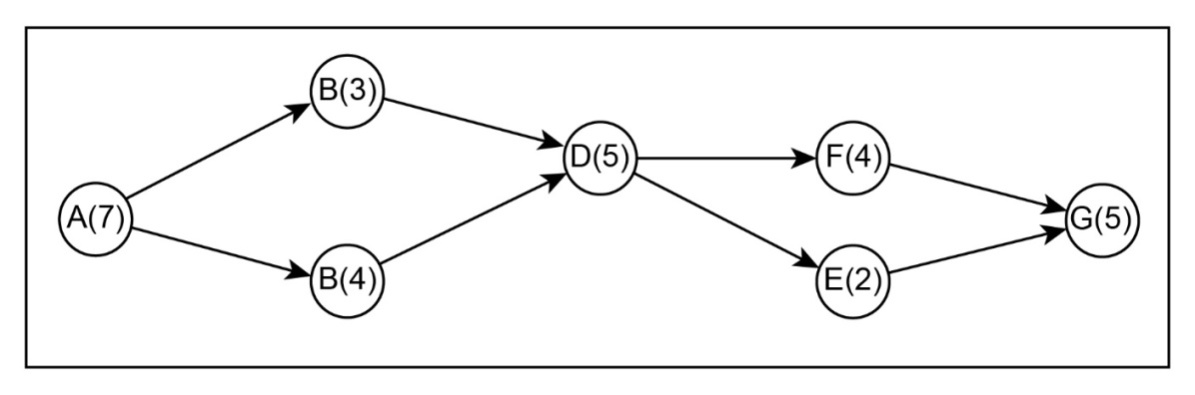

Question: Here is a network withthe activity times shown in days:


a. Find the critical path.

b. The following table shows the normal times and the crash times, along with the associated costs for each activity.


If the project is to be shortened by four days, show which activities, in order of reduction, would be shortened and the resulting cost.

Short Answer

Expert verified

Answer

The A, C, D, and F will be the movement to be decreased by 4 days and the complete crash cost of the project is $40200.

Crashing is a process used in project planning to shorten the time at the slightest amount of unnecessary price either with no purchasing costs added to the project. This is implemented by crashing several of the highly used resources.

Step by step solution

01

(a) The critical path

We can use the below table to find the critical pathof the project:

The total time of each path is given below:

The longest timeof 25 days belongs to the path A-C-D-F-G and this path would be the critical pathof the project.

02

(b) Calculation

Totalcrashtime=Normaltime-crashtimeTotalcrashcost=Normalcost-crashcostCrashcostperweek=TotalcrashcostTotalcrashtime

By using the above equation we can find the crash costsfor all the activities using excel:

role="math" localid="1650869487593" Totalnormalcost=$7000+5000+9000+3000+2000+4000+5000=$35,000

03

Crash movement A

Crash movement A is the best option because it has the lowest crash cost and is also on the critical path. It can only be crashed individually. For one day, crash it. The path duration after crashing is as follows:

Costofcrashing=Numberofweekscrashed×Crashcostperweek=1×1000=1000Totalcostcrashing=35,000+1000=$36,000

04

Crash movement D

Crash movement D is the best choice because it has the cheapest crash cost and is located on both critical paths. It can only be crashed individually. For one day, crash it. The path duration after crashing is as follows:

Costofcrashing=Numberofweekcrashed×Crashcostperweek=1×1500=1500Totalcostofcrashing=36000+1500=$37,500

05

Crash movement F

Crash movement F is the top pick because it has the cheapest crash cost and is also on the critical path. This can only be crashed individually. For one day, crash it. Ignoring the fact that it is much more pricey than E, it can minimize the duration of the two approaches. The path duration after crashing is as follows:

Costofcrashing=Numberofweekcrashed×Crashcostperweek=1×1500=1500Totalcostofcrashing=37500+1500=$39,000

06

Crash movement C

Crash movement C is the top pick and has the cheapest crash cost and is also on the critical track. Can only be crashed individually. Once per day, crash it. Because G has a larger cost than C, C should be crushed using the least crash cost model. The path duration after crashing is as follows:

Costofcrashing=Numberofweekscrashed×Crashedcostperweek=1×1200=1200Totalcostofcrashing=39000+1200=$40,200

Unlock Step-by-Step Solutions & Ace Your Exams!

  • Full Textbook Solutions

    Get detailed explanations and key concepts

  • Unlimited Al creation

    Al flashcards, explanations, exams and more...

  • Ads-free access

    To over 500 millions flashcards

  • Money-back guarantee

    We refund you if you fail your exam.

Over 30 million students worldwide already upgrade their learning with ÷ÈÓ°Ö±²¥!
